Final Clean Up Construction: A Punch List for Exterior Turnover

Exterior turnover is when a project stops being “in progress” and starts being judged like a finished property. The pavement is striped, the landscaping is in, the signage is up, and suddenly every bit of mud, metal, and loose aggregate looks like a quality issue. That’s why final clean up construction is less about one big sweep and more about a punch list, sequencing, and a short window where you stop making new messes.

This guide is built for superintendents, PMs, and closeout teams who need an exterior-ready handoff (especially on commercial sites, multifamily, municipal work, and any job with a public edge).

What “final clean up construction” means (for exterior turnover)

On the exterior, “final clean” is the stage where your site should read as complete, safe, and compliant to an owner rep, inspector, tenant, or the public.

It is different from:

  • Rough cleanup: keeping haul routes passable and controlling track-out while work continues.
  • Touch-up cleanup: small resets after last-minute deliveries, weather, and final trades.

A true exterior final clean typically includes:

  • Removing loose debris and fine sediment that makes pavement look unfinished.
  • Detailing edges where debris concentrates (curb lines, corners, and drains).
  • Clearing hazards (metal fragments, nails, and sharp scrap).
  • Protecting stormwater systems by preventing sediment from entering inlets.

For housekeeping and hazard control expectations on construction sites, OSHA’s construction housekeeping standard is a good baseline reference: 29 CFR 1926.25.

The closeout mistake that causes most rework: cleaning too early

The fastest way to “fail” final cleaning is to do it before the site is ready.

Exterior turnover cleaning works best when you create a short, protected window (often 24 to 72 hours) where:

  • Heavy deliveries are done.
  • Dumpsters are consolidated and staged.
  • Landscape and irrigation work are wrapped enough that you are not dragging soil back onto pavement.
  • Paving, patching, and striping are sequenced so you are not immediately recontaminating finished areas.

If you clean while trucks are still tracking mud, crews are still cutting concrete, or landscape crews are still pushing soil across sidewalks, you will pay for the same work twice.

Set “pass or fail” standards before you start

Final clean up construction goes smoother when you define outcomes that are easy to verify on a walkthrough.

Here are practical exterior standards that work across most sites:

  • Public edge and entrances: no visible litter, mud, or loose aggregate from the curb to the door.
  • Curb lines and gutters: curb reveal is consistent (not buried in sediment), corners are not holding piles.
  • Storm drain inlets: grates are visible and functional, no sediment ring built up around the throat, no debris stuffed along the edge.
  • Travel lanes and parking: no windrows, no scattered rock, no “crunch” underfoot when you walk it.
  • Metal hazards: no nails, tie wire, or sharp scrap in pedestrian routes, parking stalls, or drive lanes.

If your project is under a stormwater permit, keeping pollutants out of storm drains is not optional. EPA’s construction stormwater program and permit framework is a helpful reference point: EPA Construction Stormwater.

A punch list for exterior turnover (by zone)

Instead of one giant checklist, run your final clean punch list by zones. That prevents the common problem where the center looks good but edges fail the walkthrough.

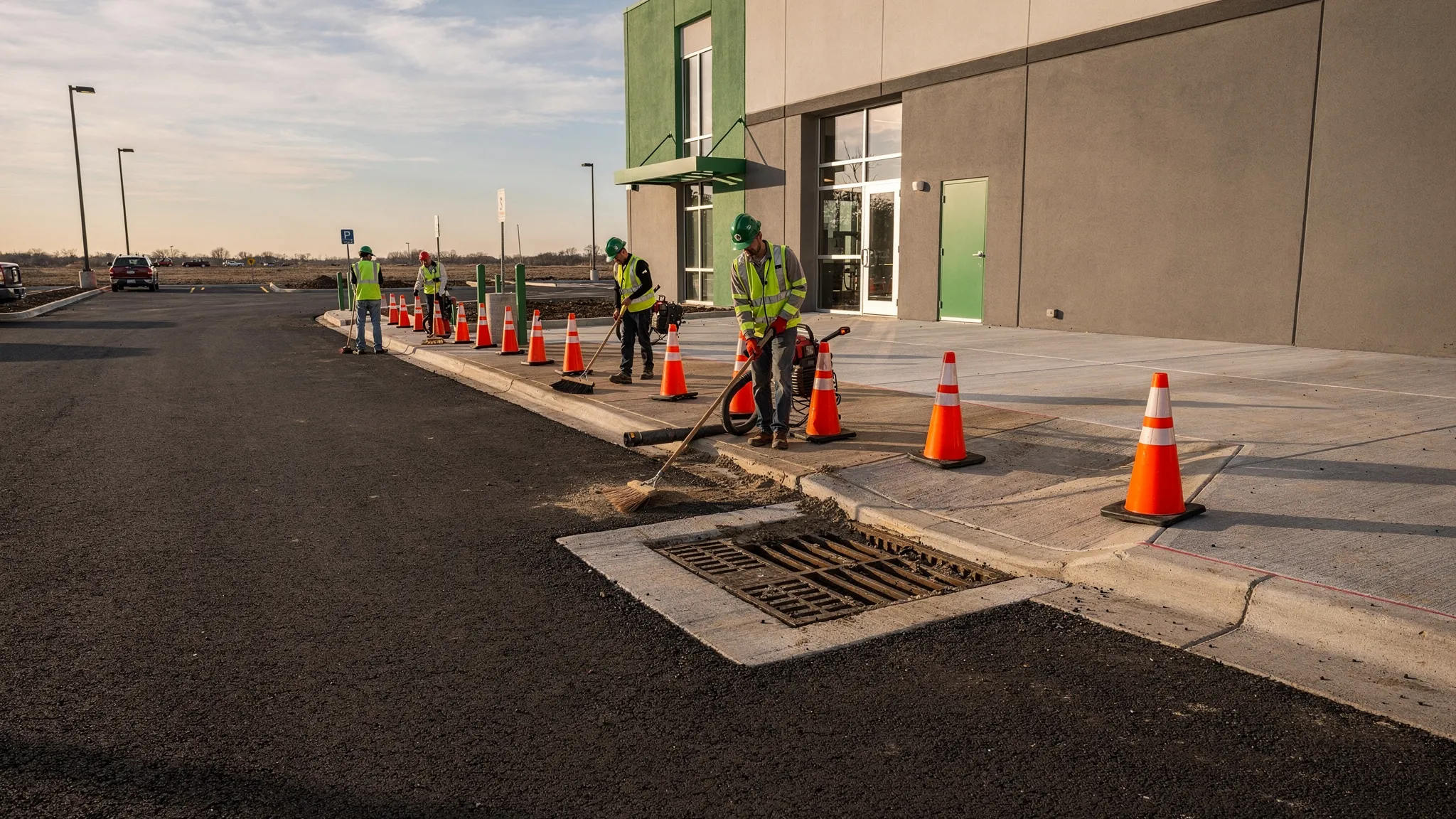

A newly finished commercial construction site entrance with clean swept asphalt, clearly visible curb line, sidewalk free of mud, a storm drain inlet visible near the curb, and a small crew doing final exterior cleanup with cones marking the work area.

Zone 1: Public edge (street frontage, sidewalks, and neighbor-facing boundaries)

This is the first-impression zone and the complaint zone.

Focus your punch list on:

  • Sidewalks: scrape and remove tracked mud, remove loose gravel, address slippery dust film.
  • Curb returns and corners: detail where material collects (especially at driveway aprons).
  • Street interface: remove any track-out and wind-blown debris beyond your fence line where your scope requires it.
  • Signage areas: clean around monument signs, posts, and bases where crews leave soil and packaging.

A quick verification method is a slow walk from the street toward the entrance, looking back occasionally. If you can see scattered debris from normal viewing distance, the site is not turnover-ready.

Zone 2: Site entrances, gate areas, and haul routes

These areas often “look clean” but still fail for safety and stormwater.

Punch list priorities:

  • Remove compacted sediment at the exit apron (the stuff that sweeping alone may not lift if it has been driven in).
  • Detail the edges where tires drop debris (gate corners, swing areas, and lane transitions).
  • Confirm track-out controls are removed only after the site is stable (otherwise the last rain event can undo your final clean overnight).

If you need a timeline-driven approach for inspection readiness, this pairs well with a pre-inspection routine like the one in Site Cleaning: What to Do Before a City Inspection.

Zone 3: Parking lots, drive lanes, and striping-ready pavement

Final pavement cleanliness is not just cosmetic. Loose aggregate and fine sediment cause slip risk, tracking into buildings, and clogged drains.

Punch list priorities:

  • Reset curb lines (remove the sediment berm that builds up where the asphalt meets curb).
  • Remove loose rock and construction trash from stalls, wheel stops, and islands.
  • Clean around light pole bases and cart corrals where debris hides.
  • Time sweeping with striping and signage installs so fresh markings are not immediately dusted over.

If you are coordinating multiple methods, a “dry first, then wet” approach prevents turning dust into slurry. Reliable Sweepers explains the field order in Cleaning and Sweeping: The Best Order for Faster Turnovers.

Zone 4: Curb lines, gutters, and drainage pathways

This is where projects lose points on both appearance and stormwater.

Punch list priorities:

  • Clear curb-and-gutter flow lines so water can move without pushing sediment into piles.
  • Clean curb returns and low spots where fines settle.
  • Remove debris at the “mouth” of drainage pathways leading to inlets.

A helpful mindset is: “If it rains tonight, where will this debris go?” If the answer is “into a drain,” treat it as a must-fix item.

Zone 5: Storm drain inlets and catch basins

Inlet areas are high-risk and often missed because crews assume “someone else has it.”

Punch list priorities:

  • Remove leaves, wrappers, and job trash around grates.
  • Remove sediment buildup around the grate perimeter and throat.
  • Verify the inlet is not blocked by landscape fabric, mulch, or curb-line windrows.

If you have a SWPPP, this is also one of the easiest zones to document with before/after photos because the “pass” condition is visually obvious.

Zone 6: Loading docks, dumpster pads, and service lanes

Owners and tenants look here first because it predicts operational cleanliness.

Punch list priorities:

  • Remove banding, pallet wrap, nails, and broken pallet fragments.
  • Detail dock bumpers, dock wells, and corners where debris accumulates.
  • Clean the dumpster pad and surrounding curb edges (especially if trash service has started).

If your project has heavy debris or you keep finding bulky material that sweeping cannot capture, see Nashville Debris Removal Services: When Sweeping Isn’t Enough.

Zone 7: Garages and ramps (if applicable)

Garages collect fine dust and track-out faster than most teams expect.

Punch list priorities:

  • Entries and ramps: remove dust and grit where tires polish it into a slick film.
  • Drains: detail around drain inlets and trench drains.
  • Stair and elevator lobbies: keep approaches free of grit and metal fragments.

(For a deeper garage-specific approach, Parking Garage Cleaning: How to Cut Dust and Track-Out is a strong companion read.)

Zone 8: Landscape edges, sidewalks, and hardscape transitions

Most exterior turnover recontamination comes from landscape work.

Punch list priorities:

  • Remove soil, mulch, and stones pushed onto sidewalks and curbs.
  • Clean around irrigation boxes, valve covers, and bedding areas.
  • Reset transitions where soil meets pavement so it does not wash out and stain the first rain.

If landscaping is still active, consider doing your final sweep as a two-step: an initial “presentation sweep” for the walkthrough, then a touch-up after the landscape crew demobilizes.

The sequencing that makes final exterior cleanup faster

A reliable sequence reduces rework and prevents the most common mistake: rinsing or wet-washing dust into storm drains.

A practical exterior turnover sequence is:

  1. Stabilize the site: stop heavy traffic in finished zones and consolidate dumpsters.

  2. Remove bulk debris first: hand-pick, scrape, and stage piles for disposal so machines are not trying to “eat” trash.

  3. Detail edges and drains: curb lines, corners, and inlets before full-field sweeping.

  4. Mechanical sweeping: run the open areas after the detail zones are addressed.

  5. Magnet sweep where metal is likely: entries, parking stalls, sidewalks near work zones, and around dumpsters.

  6. Final walk and spot fixes: treat remaining stains, gum, or mud tracking only where needed and with stormwater-safe controls.

If you expect to do any wet cleaning, keep it targeted and controlled. EPA and most local programs expect wash water to be contained and managed, not allowed to run into storm drains.

The 48-hour exterior turnover plan (simple, realistic, repeatable)

Most closeouts benefit from a short countdown that aligns trades and prevents last-minute messes.

48 to 24 hours before turnover is when you win the job.

  • Walk the site and mark zones that fail the “public edge,” “curb line,” and “drainage” standards.
  • Coordinate with trades: confirm who is responsible for scrap, pallets, concrete chips, and landscape overflow.
  • Schedule sweeping around paving, striping, and landscape demobilization.

24 hours before turnover is execution and verification.

  • Run the full sequence (bulk removal, edge detail, sweeping, magnet sweep).
  • Capture photo documentation of key zones (entrance, public edge, drains, dumpster pad).

Morning of turnover is a light touch-up.

  • Spot-check entrances, curb returns, and drains.
  • Address overnight wind-blown debris and any new track-out.

This approach complements a broader phase plan like Building Works Cleaning: A Practical Plan From Rough to Final.

Common “we thought it was clean” failures (and how to prevent them)

A few patterns show up on nearly every exterior turnover:

Curb lines look dirty even after a sweep. The fix is usually curb-line detailing first, then a full pass. If fines have compacted, they may need agitation or targeted removal before sweeping.

Inlets are technically clear but still fail visually. Crews remove the obvious trash but leave the sediment ring and debris tucked along the grate edge. Treat inlets like a detail zone, not a drive-by.

Metal hazards keep showing up. If you have tie wire, roofing fasteners, or steel work, schedule magnet sweeping as a closeout requirement, not a “nice to have.”

Landscaping recontaminates sidewalks. Hold a short “clean window” where landscape work is limited to areas that will not push soil onto finished hardscape, or plan a final touch-up after demobilization.

Nashville and Middle Tennessee reality checks

Local conditions affect final clean up construction more than most schedules account for:

  • Clay-heavy mud: once it dries and compacts, it often needs scraping or agitation, not just sweeping.
  • Fast storm cycles: a single downpour can rebuild curb-line sediment and clog inlets overnight.
  • Spring pollen and fine film: it can make “new” pavement look dusty even after a good sweep, which is why edge detail and verification matter.

If your closeout date is tight, build in a trigger plan for weather. Reliable Sweepers covers trigger-based scheduling logic in several posts, including Road Sweeping Nashville TN: Frequency, Pricing, and Results.

When it’s time to bring in professional sweeping support

Some final cleaning can be handled in-house, but exterior turnover has a short window and high expectations. It often makes sense to call a sweeping partner when:

  • You have recurring track-out, fine dust, or sediment berms at curb lines.
  • Metal hazards are present and you need magnet sweeping to reduce risk.
  • You are approaching an inspection or owner walkthrough with limited time for rework.
  • The site has complex access, tight curbs, parking structures, or public-facing frontage that must look finished.

For a scope-level view of what exterior post-construction providers typically include (and what they usually exclude), see Post Construction Clean Up Services: What’s Included?.

Frequently Asked Questions

What is final clean up construction? Final clean up construction is the last cleaning phase before turnover, focused on delivering a safe, presentable, inspection-ready site. On exteriors, it typically includes sweeping, edge detailing, drain checks, and metal debris removal.

What should be on a final construction clean punch list for the exterior? Prioritize the public edge, entrances, curb lines, storm drain inlets, parking areas, loading docks, dumpster pads, and landscape-to-pavement transitions. These zones drive most walkthrough failures.

Should final construction cleanup happen before or after striping? Usually after the major debris-producing work is done and coordinated with striping so you do not recontaminate fresh markings. Many projects do a sweep before striping, then a final touch-up sweep after.

Why is magnet sweeping important at turnover? Magnet sweeping helps remove nails, tie wire, and sharp metal fragments that can puncture tires and create injury risk, especially in parking stalls, entrances, and pedestrian paths.

Can we just power wash the exterior instead of sweeping? Power washing without dry removal can push sediment into storm drains and create compliance issues. In most cases, dry removal (detail + sweeping) comes first, with wet cleaning only where needed and properly controlled.
